Project Overview
Introdcution
The Upper Kabeli Hydro project (28.1 MW) is located at the Taplejung district of eastern Nepal.

Sailent Features
The following are the salient features of the project:
-
Company Name
Peace Energy Company Pvt. Ltd.
-
Projects
Upper Kabeli Hydropower Project
-
Capacity
28.10 MW
-
Khola
Kabeli
-

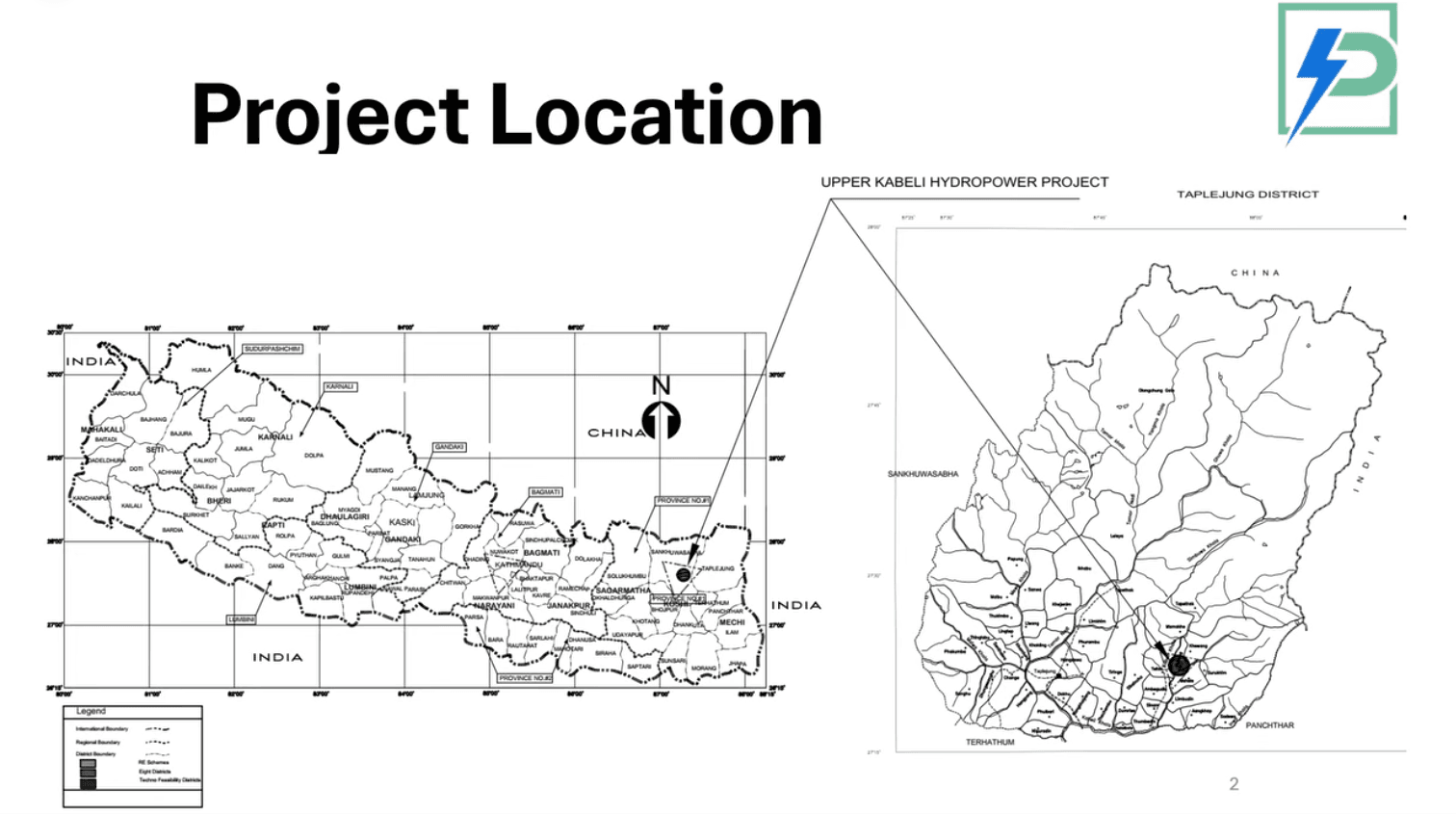

Location
Sirijangha Rural Municipality
-
Catchment Area at Intake
375.026 sqkm
-
Source of water
Kabeli Khola (Snow fed River)
-
Design Discharge (Q40%)
PPA-17.29 Cum/Sec
-
Operation Plan ( Discharge)
ROR
-
Head ( Gross )
192.10 meter
-
PPA Energy ( Yearly )
169.75 GWh -100%
-
Per MW Energy
6.040 GWH Per MW
-
Dry ( Jan to Jun)
52.17 GWh ( Per Year )
-
Wet ( July to Dec)
117.58 GWh ( Per Year )
Timeline
October, 2020
Interconnection Agreement
December, 2022
Land Procurement /Lease
January, 2022
Generation License
July, 2023
PPA
September, 2023
Access Road
December, 2023
Detailed Design/ DPR
Staff quarters/ Construction Power
Civil contract award: Package I
(Headrace Tunnel)
Financial Closure
January, 2024
Contractors Mobilization
January, 2027
COD
Construction Schedule
SN | Work Heading | Milestone Date |
---|---|---|
1 | Completion of Civil Construction Works (33 Months) | – Starting in Jan 2024 – Completing in Sept 2026 |
2 | Completion of HM Works (29 Months) | – Starting in Jun 2024 – Completing in Aug 2026 |
3 | Completion of EM Works (29 Months) | – Starting in Jul 2024 – Completing in Nov 2026 |
4 | Completion of TL Works (30 Months) | – Starting in Jun 2024 – Completing in Sept 2026 |
5 | Opening of LC of EM Works | -February 2025 |
6 | Opening of LC of HM Works | -January 2025 |
